November 21, 2026

Padma Bridge bursts into full view with the final span installed

The dream of the people of 21 southern districts to get connected to Dhaka by road nears completion as the installation of the final span has made the entire basic structure of the 6.15-kilometre Padma Bridge visible.

Muhammad Mostafigur Rahman Muhammad Mostafigur Rahman

bdnews24.com News Service

Published : 11 Dec 2020, 10:31 PM

Updated : 17 Oct 2026, 12:45 AM

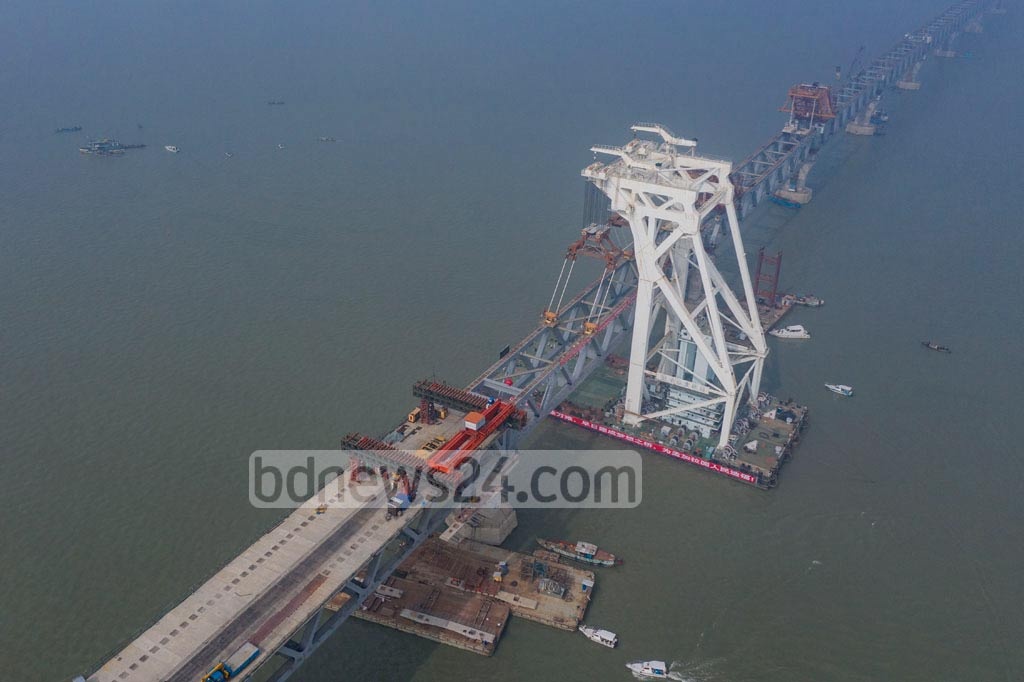

Span No. 2F, the final of the 41 spans of the Padma Bridge, was installed on piers 12 and 13 at 12:02pm on Thursday, making the main structure fully visible. Photo: Mostafigur Rahman

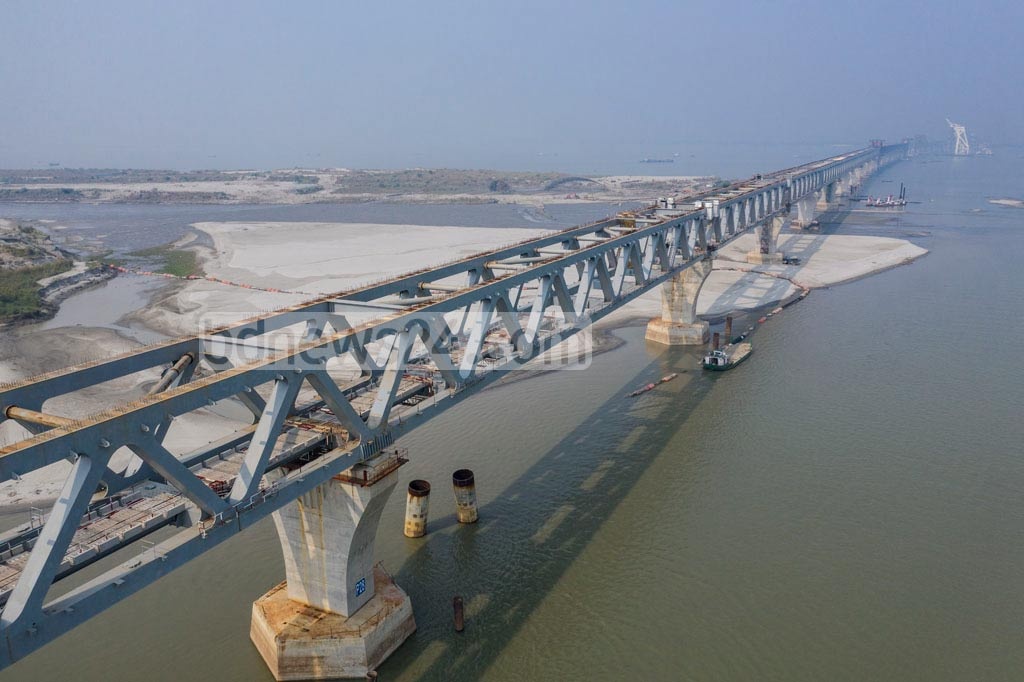

The first span was installed on piers 37 and 38 at the Zajira end of Shariatpur on Sept 30, 2017. Photo: Mostafigur Rahman

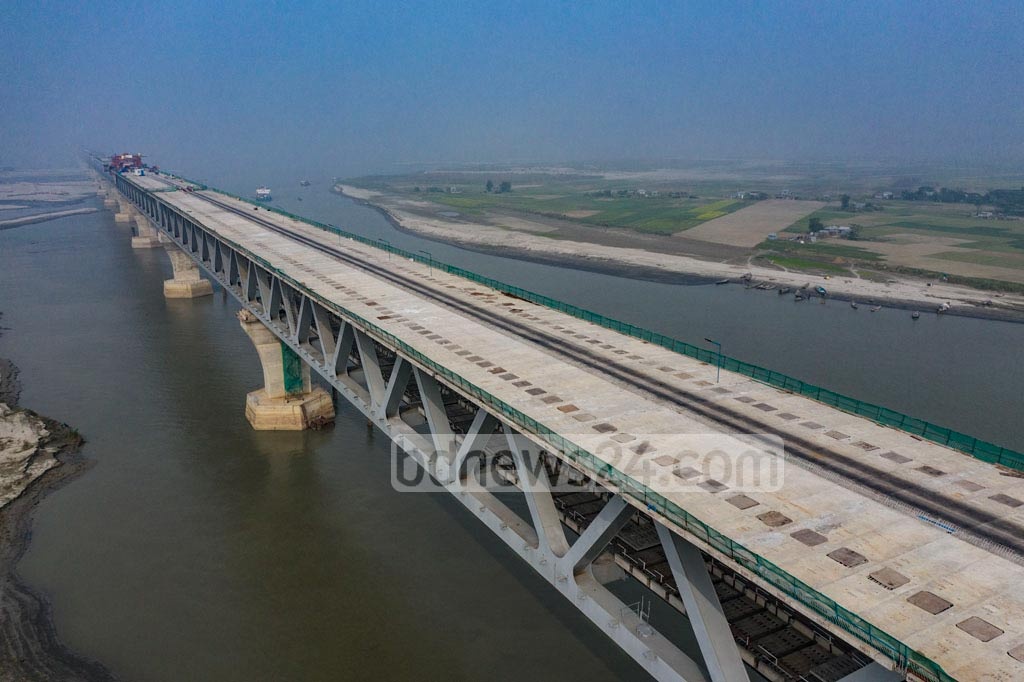

Defying many odds, the work to install the final span ends three years, two months and 10 days after the installation of the first span. Photo: Mostafigur Rahman

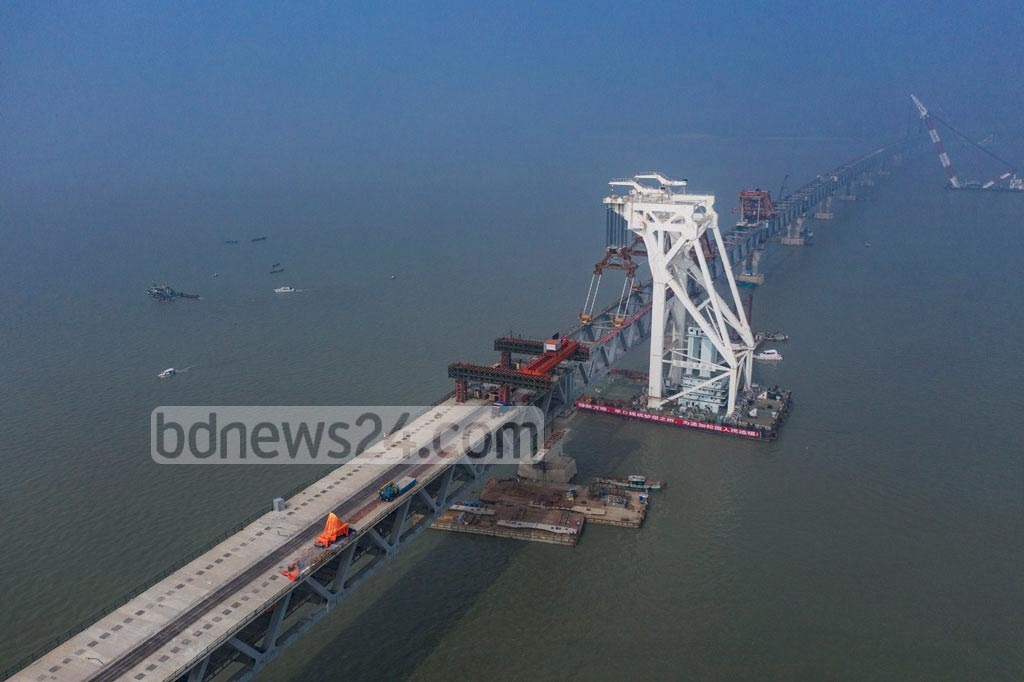

As many as 20 of the spans have been installed at the Zajira end in Shariatpur and 20 more at the Mawa end in Munshiganj while the final one was placed in the middle of the two ends. Photo: Mostafigur Rahman
Engineers struggled to build the bridge on the mighty Padma, with challenges like putting 122-metre high piles of steel with a diameter of three metres underneath the piers. Photo: Mostafigur Rahman
The constructors needed to change the design after finding soft soil below 22 piers. Later, they decided to raise the amount of piles on the consultant’s advice. The change delayed the construction by around a year. Photo: Mostafigur Rahman

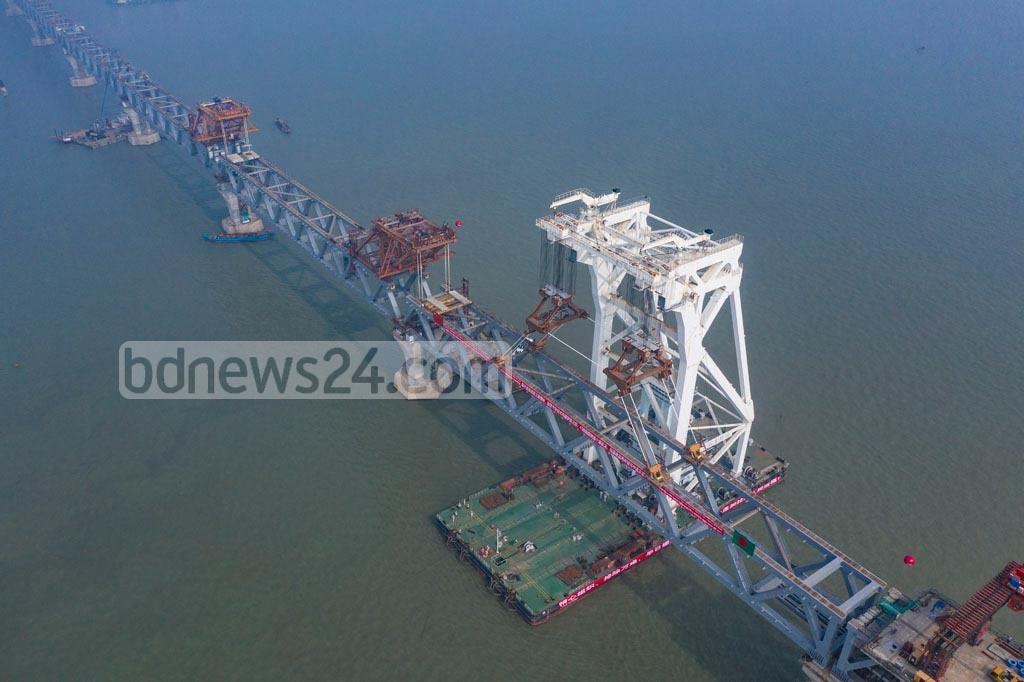

The work was hampered by the coronavirus pandemic and floods as well. Finally, the 32nd span was installed in October. The rest of the work did not take much time. Photo: Mostafigur Rahman
The pendulum bearing used in the bridge has a capacity of 10,000 tones. Engineers say it can withstand a magnitude 9 earthquake. Photo: Mostafigur Rahman
Each of the 150-metre long spans weighs around 3,200 tonnes. A floating crane from China was used to carry and install the spans from Kumarbhog Construction Yard at Mawa. Photo: Mostafigur Rahman

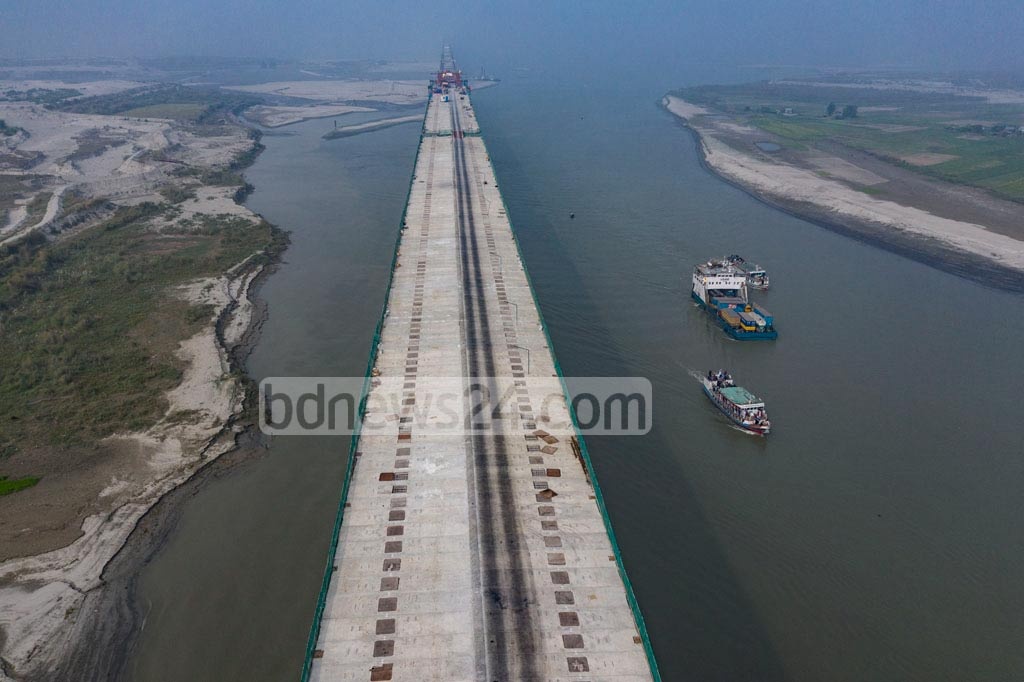

As many as 21 southern districts will get connected to Dhaka through road once the 6.15-kilometre bridge opens. Photo: Mostafigur Rahman

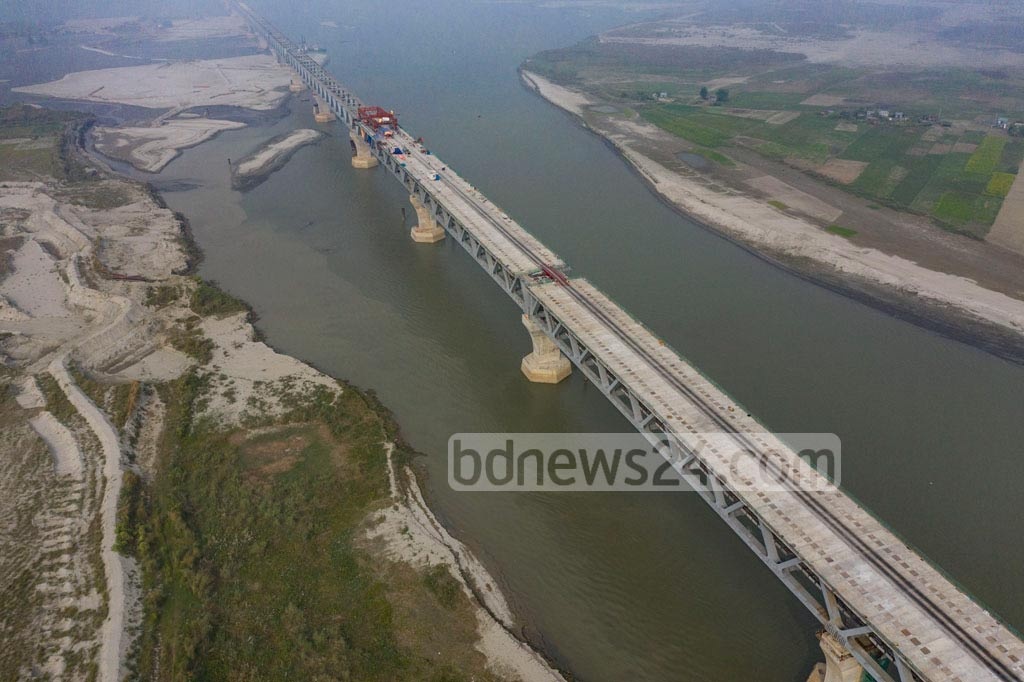

After the installation of the final span, Cabinet Secretary Khandker Anwarul Islam said it will be possible to open the bridge to traffic by June 2022. Photo: Mostafigur Rahman

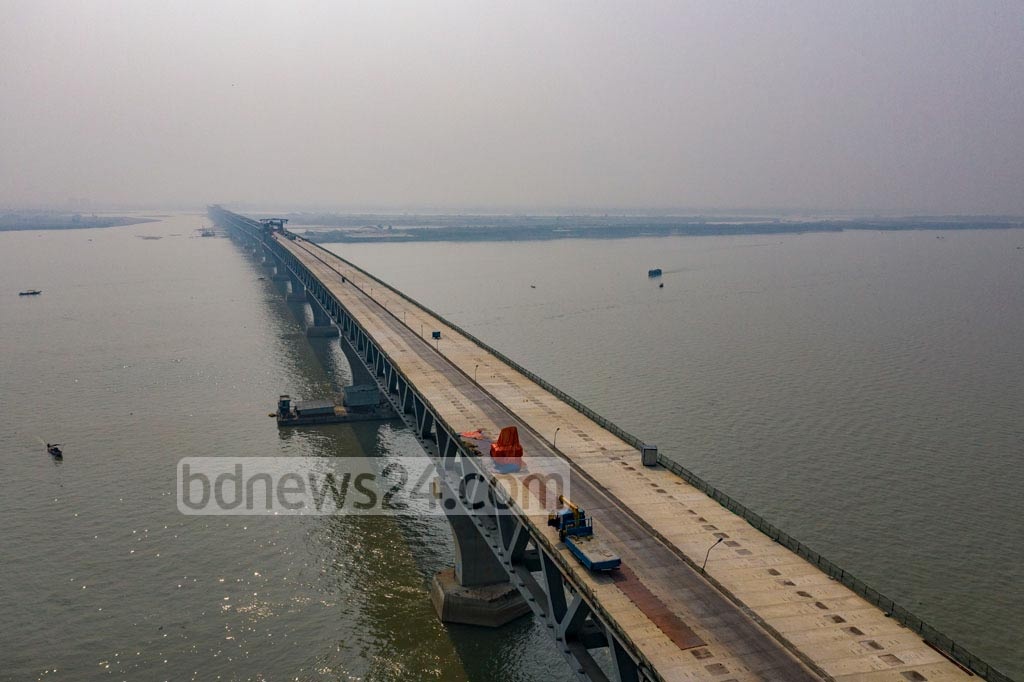

The work to put pitch will start after concrete slabs are installed on the 22-metre wife two-story bridge with four lanes. Photo: Mostafigur Rahman
The multipurpose bridge will be used for broad gauge and meter gauge train links on a single railway. Photo: Mostafigur Rahman
Mongla Port and Benapole Land Port will get connected to Dhaka and Chattogram Port directly through road once the Tk 301.93 billion project ends. Photo: Mostafigur Rahman
